Multiple Pathways to Graduation Building

  • Construction began in the fall of 2022 on the Multiple Pathways to Graduation (MPG) building adjacent to the Benson Polytechnic campus. The MPG Building will include Alliance at Benson and Meek, DART/Clinton, Teen Parent Childcare, Reconnection Services & Program. In the modified Benson Master Plan, additional classroom space will be allocated within the Benson Polytechnic High School campus to accommodate Portland International Scholars (PISA), Pioneer High School, Portland Evening and Summer Scholars and Portland Virtual Scholars. For more information about Multiple Pathways To Graduation please visit their website by clicking here.

    The new MPG Building will open in the fall of 2024.

  • Project Updates

    Construction updates Fall 2023 - MPG filling out!

    West side of the new MPG building

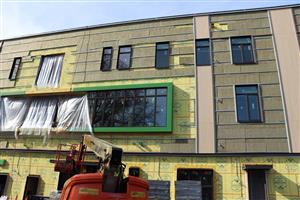

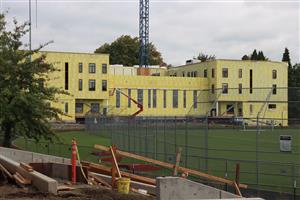

    The new MPG high school is getting ready for the wet winter months. The building has been enclosed with exterior sheathing and the first roofing layers. The final exterior panels will be installed in the next few months. Windows are being put into place using the tower crane.

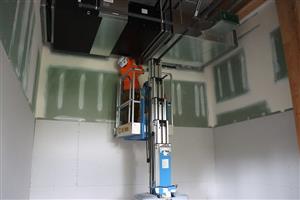

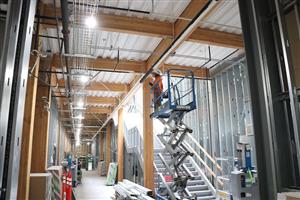

    worker on lift

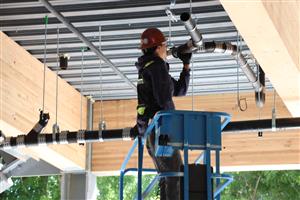

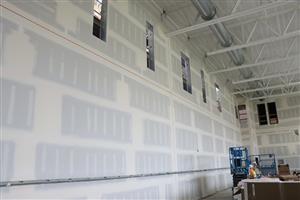

    The ground floor has walls framed and drywall cover in a few of the CTE program spaces for Automotive and Manufacturing.
    Wide hall with framing & workers

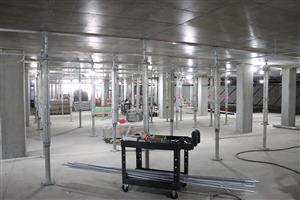

    The mechanical, electrical and plumbing work is in various stages of installation across the site. It is the farthest along on the ground floor where mechanical ducts are being installed. The second floor has fire protection, electrical, and plumbing installed. The third floor is in the process of having the steel framing erected to allow the rest of the work to follow.
    Outside 3rd floor deck work

    The accessible roof deck is an exciting addition to this project and has the first roof layer installed. Teams will come back next year and install the full roof insulation layers and roof cap sheet when the weather is better suited.

    Female construction working installing metal plate

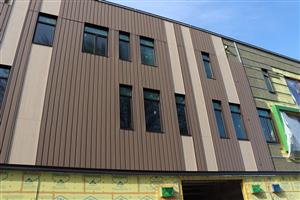

    Each floor is in a different state of progress and shows how construction teams move from one space to the next as the building comes together. On the ground level, the bike shelter roof has been installed. The bike shelter roof will have solar panels fixed to them later in construction.

    Construction updates Summer 2023 -MPG is taking shape!

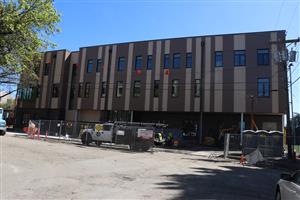

    East side of MPG building showing framing of 3 stories
    Looking down on the new gym unde construction from 2nd floor

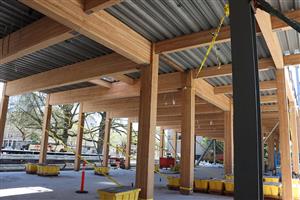

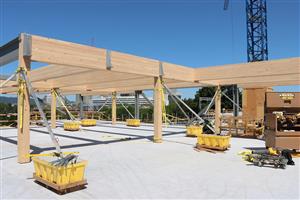

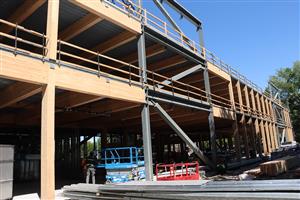

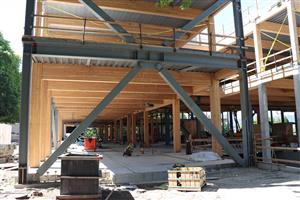

    The Multiple Pathways to Graduation building is really taking shape. All three floors of the Mass Timber framing are complete.

    Mass Timber framing seen on two floors fom the north side
    The team poured the southern half of the roof yesterday and will pour the rest of the roof next week. Interior wall framing is almost complete on the first floor and soon the crews will be working either way up to the second floor.
    3rd floor of MPG with wood framing

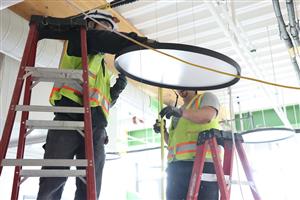

    Interior framing is followed closely by the electricians, plumbers and low voltage installers providing all of the infrastructure for the new building.
    Worker adding piping in the ceiling
    One of the aspects of the new building that is really noticeable now that all three floors are framed is the amount of natural light that will come into the building and the views into the trees and across the river.

    Construction updates May 2023 - Going up!

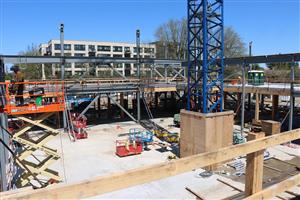

    Overview of MPG building construction
    Wood framing on the first floor

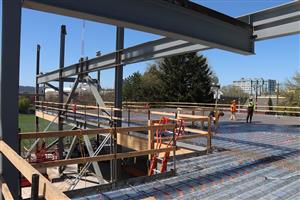

    The MPG building is going up quickly! The second floor will have the rest of the concrete floor poured in the coming week after the reinforcement is installed. The second floor recently poured is in the process of curing.
    2nd story Cement floor is curing
    The engineered wood structure of the second floor is being erected with members put into place by the tower crane. Workers have also been adjusting the structural connections as more of the building comes together.
    Steel beam framing on 2nd floor
    The metal joists for the gym's roof have been staged and are ready to be put in place.
    Underground Parking lot framing & plumbing
    Plumbing rough-in has begun in the basement car park.  Check out the latest construction photos here.

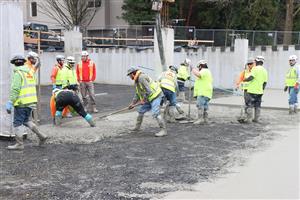

    Construction updates March 2023 - Big concrete pours.

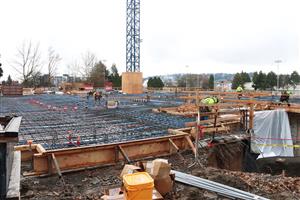

    Wide of first floor ready to pour concrete

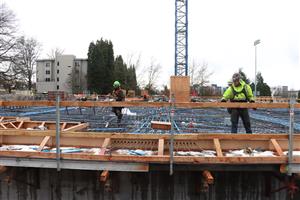

    Workers on site MPG doing framing

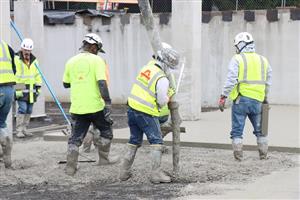

    The Multiple Pathways to Graduation building saw its first major concrete pour in February. The team recently poured one half of the post tensioned concrete slab, comprising the first floor under the CTE Manufacturing and Automotive shops.

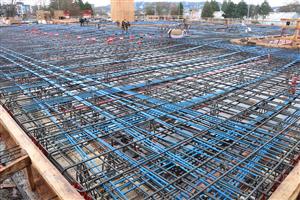

    second half of the first floor, post tensioned slab rebar
    The second half of the first floor, post-tensioned slab will be poured in early March. The concrete and structural aspects of the parking garage level are mostly complete.

    Crane delivering materials for workers
    The structure of the MPG building will be a mix of Mass Timber and steel. The first steel has arrived on site and installation is now underway. The project team recently visited the mass timber supplier and are happy to report that production is underway and of the highest quality. Mass Timber has a low carbon footprint, yet it is both strong and fire resistant and offers an alternative to other fossil fuel-intensive materials.

    Construction updates Feb 2023 - MPG Building starting to rise up!

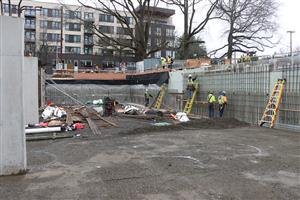

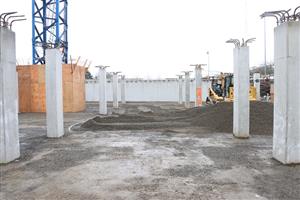

    Foundation pillars for MPG foundation
    Retaining walls on the underground parking area
    The new Multiple Pathways to Graduation building is rising out of the ground.
    Crane on the MPG site

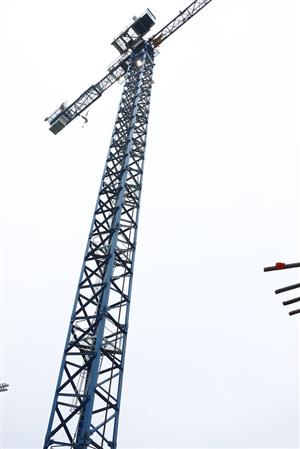

    In the center of the site you will see a large crane that will be in place throughout construction.
    Framing on retaining wall

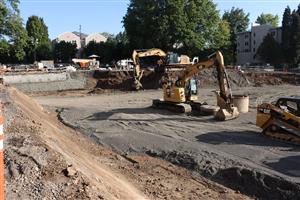

    The team has completed the mass excavation of the site and it's almost complete with the parking lot walls and floor.

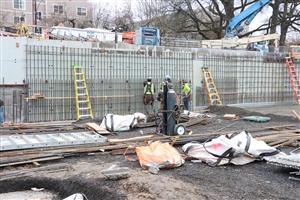

    cement pour MPG
    Cement pour close up
    They have started to lay the formwork for the Post Tensioned slab that will be the first floor of the building, which will be poured in the next couple of weeks.

    Construction updates Oct/Nov 2022

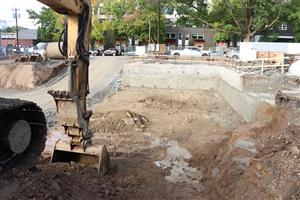

    excavation work on MPG site
    Excavation and site work is well underway on the site and the building footprint is starting to take shape.
    Shows the driveway and new entrance site work
    You can start to see where the parking garage will be located, including the driveway and new entrance. A tower crane will be set in place in mid-November to assist with construction efforts.
    MPG rendering view from Buckman
    MPG is designed to be a Mass timber and steel building and is planned for LEED Gold certification. Construction will take place over the next two years and the MPG building will open in the fall of 2024 at the same time as Benson Polytechnic. See the latest MPG Building construction photos here.
